Operational in just 6 months, cutting the total delivery cycle by 270 days

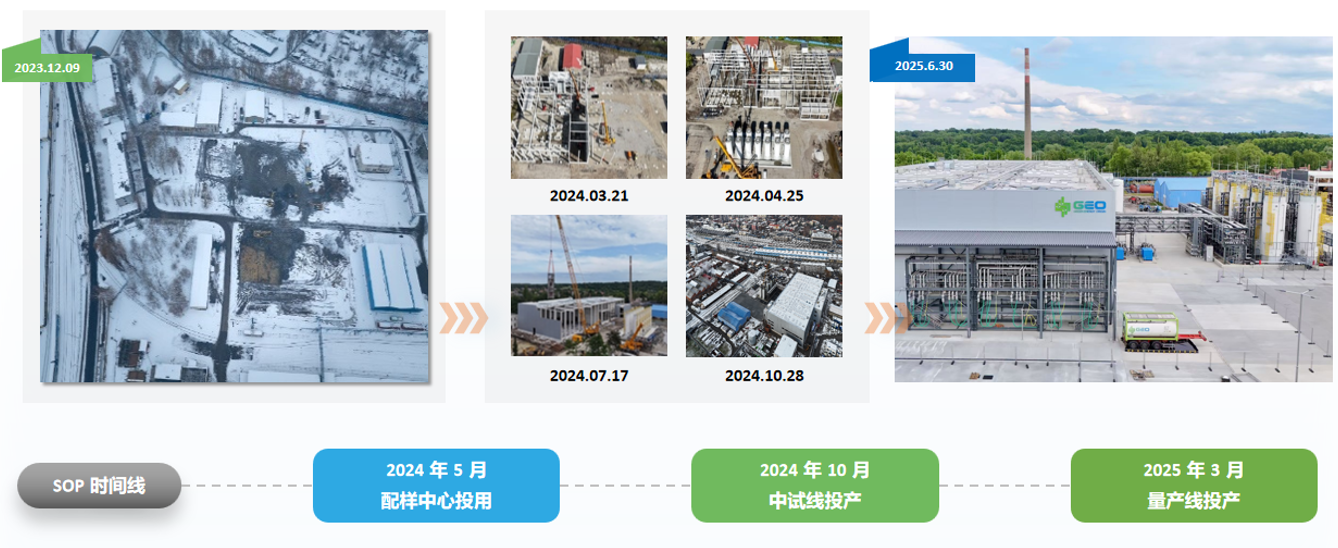

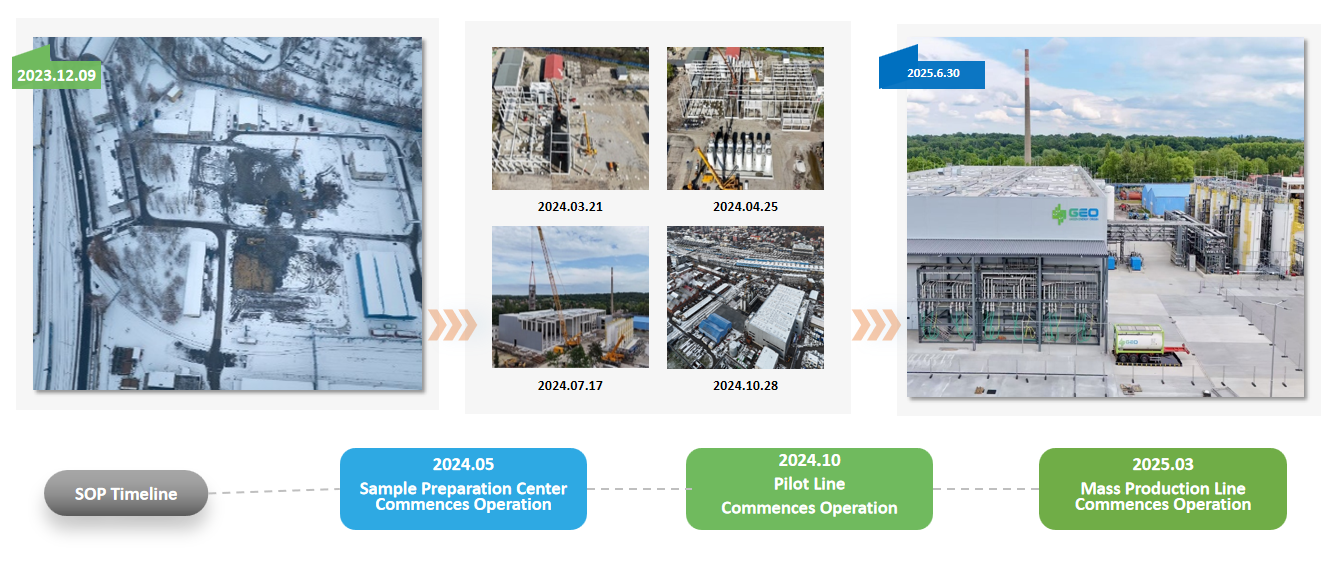

2023.12: Construction started — 2024.5: Formulation Center operational — 2024.10: Pilot Line began production.
Highly automated: labour input reduced by more than 50%

Highly modular: significantly reduces construction time and minimises risks

・System-Level Modular Design
Decompose the plant into prefabricated functional modules, enabling design, manufacturing, and testing to run in parallel — breaking away from traditional linear construction workflows.

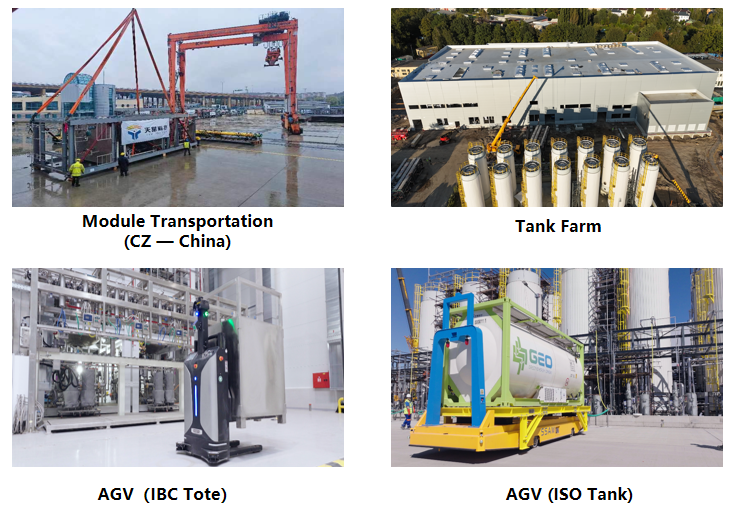

・Prefabricated in China, Assembled Globally
Core modules are precision-manufactured and pre-tested in domestic workshops, then shipped to the site for rapid, building-block-style assembly and integration — dramatically shortening overseas construction timelines.

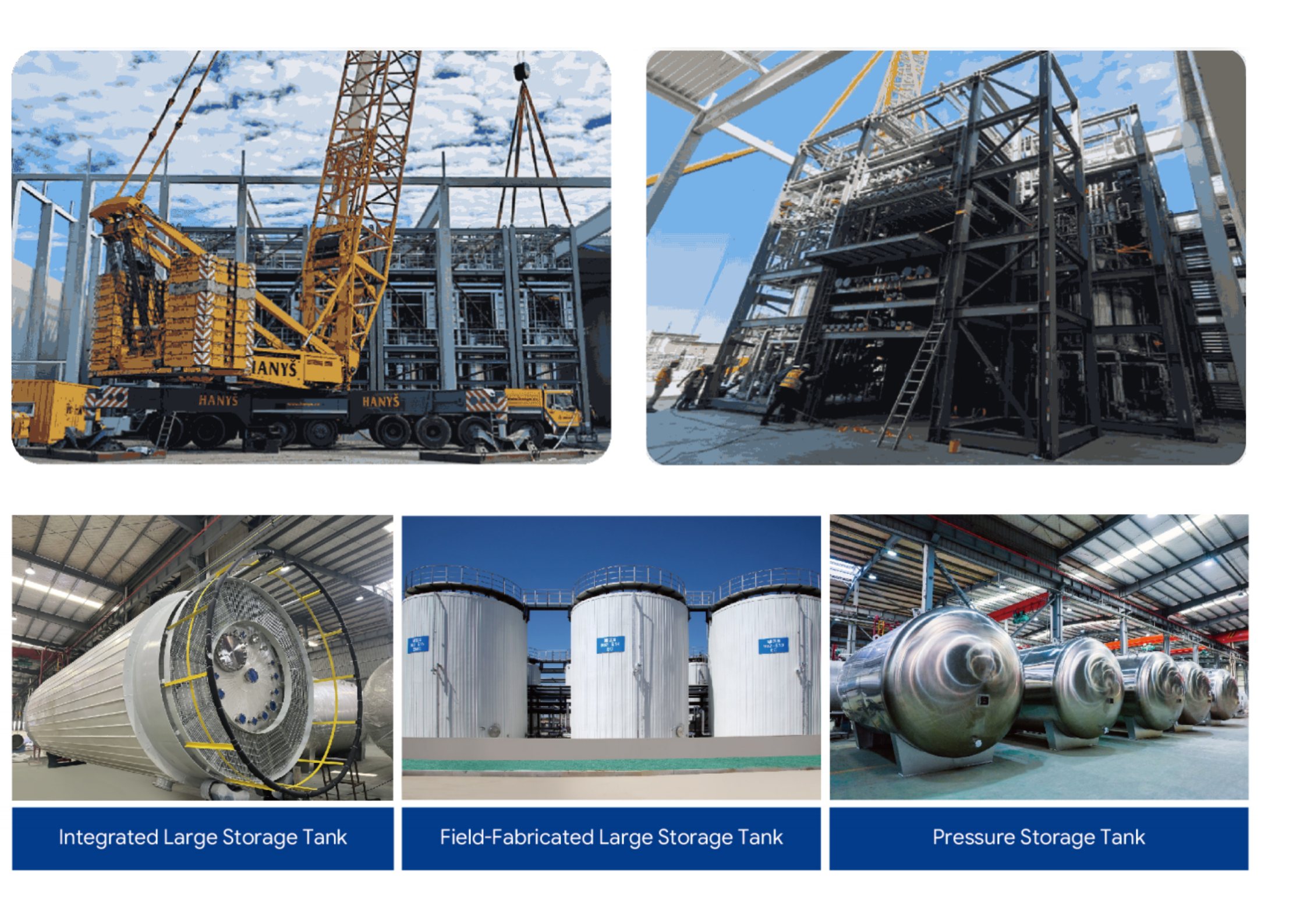

・Prefabricated in China, Assembled Globally
Large storage tanks are efficiently assembled on-site, eliminating the challenges of transporting oversized equipment.
Localized Services & ESG Commitment
・Compliance-First Strategy
Local regulatory research is embedded from project initiation, ensuring all mandatory requirements — environmental, labor, and safety — in the EU and host countries are met from the design stage.
・European Warehousing & Logistics Centre
A regional supply chain hub is established to stock critical spare parts, enabling rapid delivery and emergency response.
・International Quality & Standards
Products and key equipment meet both CE (EU) and ASME (International) standards, securing global market access credentials and quality credibility.
・Deep ESG Integration
Green construction and operations: adopting low-carbon materials and processes during construction. Through highly modular prefabrication, on-site wet work and waste generation are reduced by over 60%.
